On ScheduleSite Progress VerifiedLast activity 37d ago · Site Inactive

Panorama View Residences

Acorn Holdings Ltd · Westlands, Nairobi · Setting the Standard for real estate developments in Nairobi upmarket areas.

Construction Health
On Schedule
Last Site Activity
37 days ago
Last Milestone
Superstructure
Update Frequency
Every 14 days

Milestone Progress

60%
  1. Pre-ConstructionDone Jul 2026
  2. FoundationDone Jul 2026
  3. SuperstructureDone Jul 2026
  4. Building EnvelopeIn Progress
  5. Practical CompletionIn Progress

GPS-Verified Photos

Verified Progress Timeline

Every record is GPS-locked, timestamped, and admin-reviewed before appearing here.

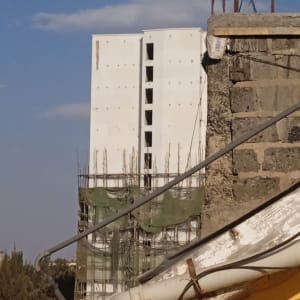

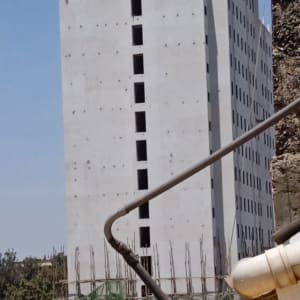

  • Finishing Works📍 Location & Timestamp Verified✓ Record Approved26 Aug 2026

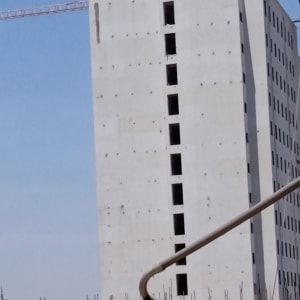

    External wall painting

    The external walls of the building have been painted from the second floor to the top most floor. The windows opening to the outside have also been painted. The building is on track towards completion later this year.

    📸 2 photos📍 -1.10036, 37.01734
    Progress at upload60%

  • General Update📍 Location & Timestamp Verified✓ Record Approved26 Aug 2026
    Site Progress Update

    External painting has been done from the second floor to the fifteenth floor of the building. The only levels remaining to be painted are the ground and the first floor. The building remains on course towards completion.

    📸 3 photos📍 -1.10018, 37.01709
    Progress at upload0%
  • General Update📍 Location & Timestamp Verified✓ Record Approved26 Aug 2026
    Site Progress Update

    External painting has been done from the second floor to the fifteenth floor of the building. The only levels remaining to be painted are the ground and the first floor. The building remains on course towards completion.

    📸 3 photos📍 -1.10016, 37.01702
    Progress at upload0%
  • General Update📍 Location & Timestamp Verified✓ Record Approved25 Aug 2026
    Site Progress Update

    The external wall painting of the building is almost done. The painting is completely from the second floor to the fifteenth floor. Only the external walls for the ground and first floors are yet to be completely painted. The building is on course towards the full completion slated for later this year.

    📸 3 photos📍 -1.10028, 37.01709
    Progress at upload0%
  • General Update📍 Location & Timestamp Verified✓ Record Approved25 Aug 2026
    Site Progress Update

    The external wall painting of the building is almost done. The painting is completely from the second floor to the fifteenth floor. Only the external walls for the ground and first floors are yet to be completely painted. The building is on course towards the full completion slated for later this year.

    📸 3 photos📍 -1.10036, 37.01707
    Progress at upload0%
  • General Update📍 Location & Timestamp Verified✓ Record Approved25 Aug 2026
    Site Progress Update

    The external wall painting of the building is in progress and is nearing completion. The building's 2nd to the 14th floors are already painted on all facets. The only external walls remaining to be painted are the walls from the ground floor to the first floor of the building. The building is on track towards completion and handover.

    📸 4 photos📍 -1.10021, 37.01705
    Progress at upload0%

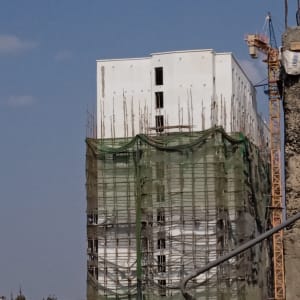

  • Structural Works📍 Location & Timestamp Verified✓ Record Approved12 Jul 2026
    Building envelope works completed from Floor 1 through Floor 15.

    Building envelope works have been completed from Floor 1 through Floor 15. This includes the installation of the external walls, facade elements, and structural openings, marking significant progress in enclosing the building and preparing the completed floors for internal works.

    📸 3 photos📍 -1.10014, 37.01709
    Progress at upload70%
  • Milestone Completed📍 Location & Timestamp Verified✓ Record Approved8 Jul 2026
    Floors cast and cured

    The superstructure works for Panorama View Residences are now fully complete.

    📸 2 photos📍 -1.10017, 37.01710
    Progress at upload0%

  • Structural Works📍 Location & Timestamp Verified✓ Record Approved8 Jul 2026

    Superstructure Progress - levels 13 to 15 Complete

    Superstructure works continue steadily, incorporating the enhanced design specifications. Levels 13 through 15 are fully cast and cured. The team is currently working on level 16. MEP rough-in works, including electrical conduits and plumbing sleeves, are progressing on levels 1 through 10. Internal block work is complete on level 1 through 10. The project is tracking toward Milestone 3 completion.

    📸 3 photos📍 -1.10025, 37.01697
    Progress at upload0%
